Total and Average Overtime KPI
Total and Average Overtime KPI is a project management
KPI that shows the total and average number of overhead hours the resources
work in access of regular working hours scheduled for a project. This KPI
allows to estimate how successful resources and work are allocated between
projects.
To define Total and Average Overtime KPI values please
follow the steps below:

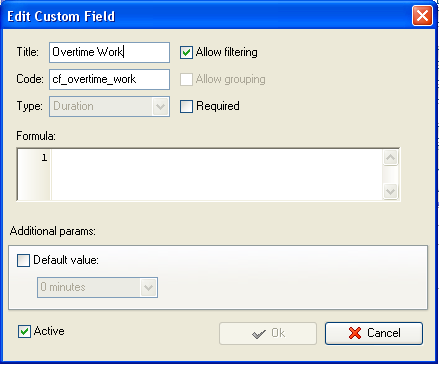

- Create the custom field "Overtime
Work"
![](/images/tutorial/total-and-average-overtime-kpi2.png)
- To enable the displaying of total and average value of this KPI select

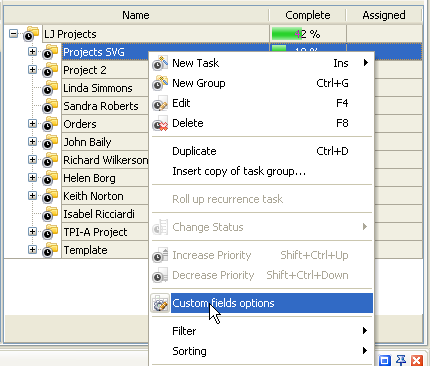

the root or parent task group and click "Custom fields options"
![](/images/tutorial/total-and-average-overtime-kpi4.png)
- In "Edit custom fields options" window select the following
options:
- select custom field "Overtime Work"
- select "This Task Group" in the
field "Settings for"
- select "Enable"
- check "Aggregated (for task group)

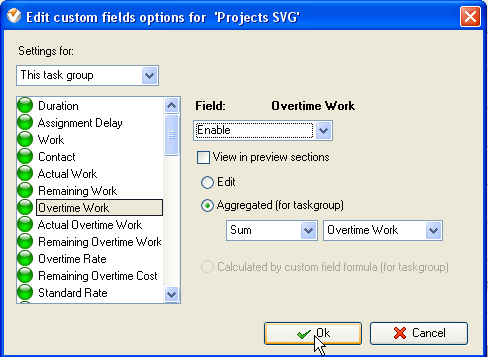

- to display the total overtime hours for projects select "Sum" and
the custom field name "Overtime Work"
![](/images/tutorial/total-and-average-overtime-kpi6.png)

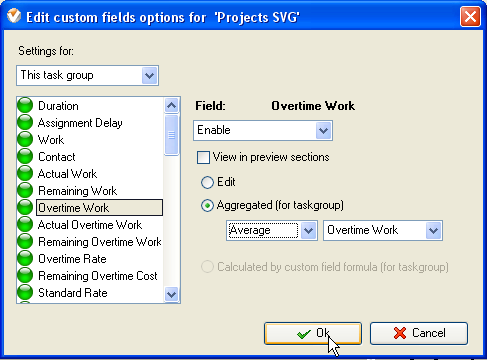

- to display the average overtime hours for projects select "Average" and the custom field name "Overtime Work"
![](/images/tutorial/total-and-average-overtime-kpi8.png)
![](/images/tutorial/total-and-average-overtime-kpi10.png)

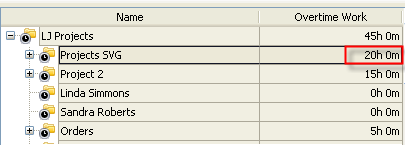

Total Overtime KPI for projects on Task Tree
![](/images/tutorial/total-and-average-overtime-kpi12.png)

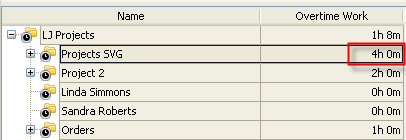

Average Overtime KPI for projects on Task Tree
|
